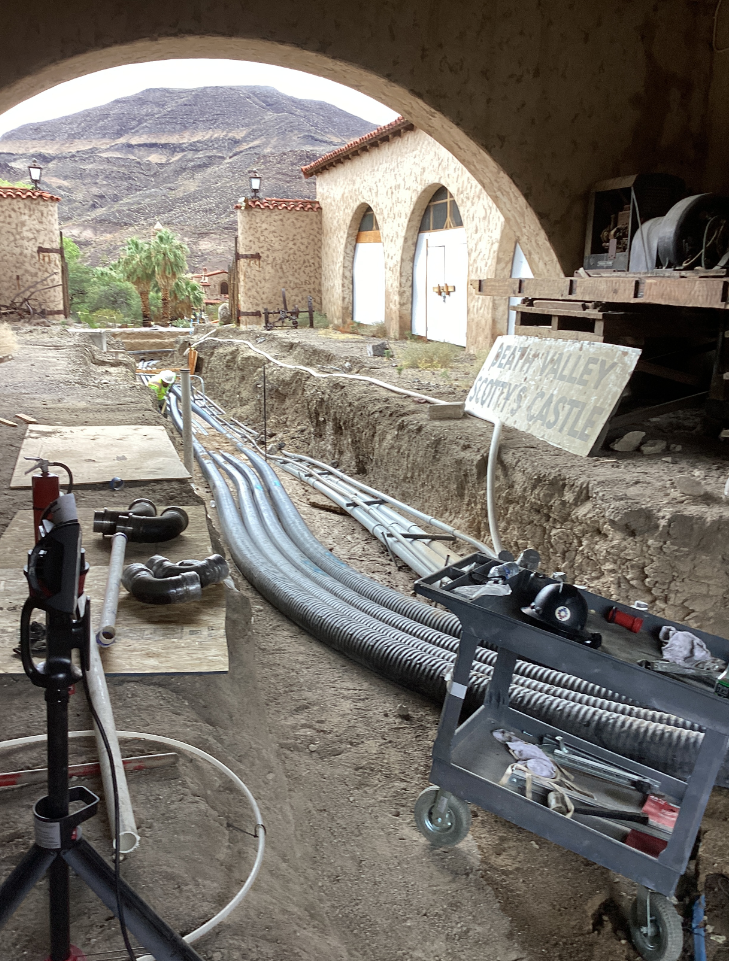

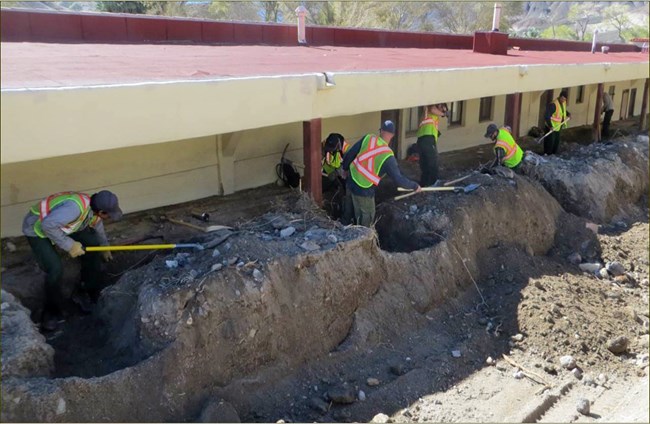

|
NPS photo Unprecedented RainfallOn the night of October 18, 2015, Scotty's Castle received 2 3/4 inches of rain— a year's worth of rain within a mere five hours. This followed a half-inch of rain the day before. The rain and hail fell on the steep slopes of Grapevine Canyon and quickly caused a flash flood of mud and rocks headed towards Scotty's Castle flowing at an estimated 3,200 cubic feet per second. Limited Tours Before Full ReopeningA limited number of public tours are offered late Fall through early Spring though a partnership with Death Valley Natural History Association. This provides opportunities to visit the historic district while project work continues.There is no definite reopening date for Scotty's Castle, but the soonest possible date is November 2028. Once the projects are completed and the museum collection is returned to the historic house, the National Park Service plans to open Scotty's Castle seasonally each year, from late Fall through early Spring. NPS What is taking so long?Delays have been due to funding challenges, staffing challenges, compliance with laws to protect historic and natural features, contracting issues, unforeseen conditions, the pandemic, additional flooding, and a fire. These challenges compounded each other. For example, when contract bids on a large project came in more than one million over budget, that project got delayed a year while we tried unsuccessfully for a lower price, then secured additional funding. Funding challengesThe repairs cost about $71 million. Park managers split the work into separate projects for funding reasons. Generally, the NPS formulates funding for large projects three to five years in advance. This meant Death Valley NP needed to postpone previously planned projects. Fund source: NPS emergency contingencyThe National Park Service holds some money in contingency every year for emergencies that happen anywhere in the hundreds of NPS units. Death Valley National Park received money from this emergency funding for the most time-sensitive needs. These included: initial road access to rescue stranded employees and park visitors at Ubebehe Crater, Mesquite Springs Campground, and Grapevine; curators and conservators traveled to the park to stabilize water-logged historic artifacts; and site security. Fund source: Federal Highway AdministrationFederal Highway Administration (FHWA) has funding for large-scale damage done to federally-owned roads through the Emergency Relief for Federally Owned (ERFO) Roads program. This program paid for the rebuilding of 8 miles of Bonnie Clare Road (aka Scotty's Castle Road). Fund source: DonationsDonations are mainly paying for conservation of musuem artifacts, such as the leather curtains that hang in the Great Hall and the magnificent theater pipe organ. Donations are being accepted by the park's nonprofit partner, the Death Valley Natural History Association (DVNHA).Fund source: User recreation feesDeath Valley National Park collects about $4 million each year from entrance fees, sale of passes, and camping fees. 80% of this money is retained in the park and can only be spent to provide direct benefit to park visitors. (The other 20% goes to a national pool of funding for projects that benefit visitors in smaller parks.) This is authorized under the Federal Lands Recreation Enhancement Act (FLREA). Park visitation has been reduced since the COVID-19 pandemic (largely due to reduction of international travelers in the summer), which has reduced the park's available recreation fees for Scotty's Castle projects. Meanwhile, everything got more expensive during and after COVID. Death Valley is using recreation fees to pay for the following aspects of Scotty's Castle recovery: construction of large berms to protect the site from future flash floods, replace the parking lot, replace pedestrian walkways, repair the Longshed building, repair storm damage to Scotty's Castle main house, repair storm damage to the Chimes Tower, replace destroyed sections of the historic concrete fence visible along the road, stabilization of the Gate House/Bridge, off-site storage of the historic furniture, and landscaping.Fund source: NPS Line Item ConstructionThe National Park Service has a Congressionally-appropriated fund source known as Line Item Construction, which is intended for the largest projects across the NPS. Typically, a park like Death Valley could hope for one Line Item Construction project funded every 5-10 years. Two Scotty's Casltle projects got funded this way: repair of the historic Garage (in use as Visitor Center) and replacement of the flood-damaged heating, ventilation, and AC system for the Castle's main house. These projects together were about $15 million. Fund source: NPS Repair/RehabilitationThe Repair/Rehab fund source is also Congressionally-appropriated. Projects must cost under $2 million to be eligible. In order to qualify for this fund source, park managers split projects into discrete subprojects that were funded and contracted separately. For example, water system repairs were done in four projects: 1) temporary water line on the surface that only serviced the fire risers, 2) replace 4.000 feet of water main from the spring to the historic campus, 3) replace the destroyed spring gallery and historic water tank, and 4) replace/repair damaged supply lines within the campus. This fund source is also paying for 3 projects to replace the destroyed sewer lines, septic tanks and leach field; 2 projects to repair damaged electrical system components, 2 projects to replace damaged communications and alarm system, and repair the historic Hacienda building (which had two employee apartments and staff offices). Unforeseen ConditionsSome issues only became apparent once repair work started. Some of these new-found issues meant new funding proposals needed to be written. Others meant that contracts needed modification. For example, park managers didn't know there was damage to the sewage collection pipes until after the water main was repairs so the pipes could be tested. PandemicCollateral impacts of the COVID-19 pandemic impacted Scotty's Castle timeline. Contractors and NPS personnel were affected by the illness directly and by pandemic travel restrictions. The disruption of the global supply chain meant key items were not available, or were delayed by many months. It took 4 months to get a large, sturdy tarp to cover the contaminated ash left behind by the Garage fire. Operations halted during this time because wind was blowing around fine ash containing asbestos and heavy metals. Contract costs consistently came in higher than expected, possibly related to the 'Great Resignation'. At the same time, park revenue was reduced by a significant drop in international tourism. FireOn April 22, 2021, contractors arrived at Scotty's Castle to find the historic Garage completely on fire and flames were spreading the historic Longshed. Historic buildings are uniquely vulnerable when they are being worked on. This project was 60% complete. Ironically, one of the upgrades being done while flood damage was being repaired was to install fire sprinklers.More FloodsDeath Valley National Park experience major flash floods in 2022 and 2023. Fortunately, these events did not damage Scotty's Castle and only did small amounts of damage to Scotty's Castle Road due to the flood resiliency improvements made during this recovery. However, there was extensive damage done to roads and facilities in the rest of the park, which diverted NPS staff's work away from Scotty's Castle.Compliance with NEPA and NHPA lawsAny project using federal funds or taking place on federal lands needs to be reviewed to minimize impacts to historic features, sites important to local tribes, impacts to rare and threatened species, and more. This is required by the National Environmental Policy Act (NEPA) and Section 106 of the National Historic Preservation Act (NHPA). Repair Progress
NPS Flood ControlThe previous earthen berms washed away in the 2015 flood. Newly engineered flood control structures were necessary to protect the historic district from future floods.COMPLETED 2019: Numerous small flood control features were included in the redesign of Bonnie Clare Road. COMPLETED 2020: Large berm lined with rock-filled gabion baskets was constructed upstream of the water system's source. COMPLETED January 2023. This project was funded by user recreation fees (entrance and camping). This installed a large earthen and gabion basket berm on the uphill side of the historic district, a small flood wall behind the Hacienda, a small flood wall behind the Cook House, and a concrete-lined ditch behind the Stables. These flood control structures successfully protected the historic district from damage during flooding caused by the remnants of Hurricane Hilary on August 20, 2023. NPS photo Visitor Center (historic garage/longshed)The most severely damaged historic building was the garage/longshed building. This large L-shaped historic building has a breezeway connecting the garage, which functions as the site's Visitor Center, and the longshed, which contained staff offices, first aid room, and the historic chicken coop. The flood broke through windows, doors, and walls. The flood left four feet of mud and rocks inside the building. NPS photo Historic BridgeThe bridge created a pinch point for the flood, which caused the water and debris to rush under the narrow bridge span like water rushing through a hose when pinched. The ground under the bridge and around its foundation was scoured down by about 8 feet. Articulated concrete block and other erosion-control features have been installed upstream and downstream of the bridge. Soil has been backfilled over the erosion control devices, so vegetation will disguise them.REPAIRS COMPLETED.
NPS / Lou Rogers Scotty's Castle Road (Bonnie Clare Road)The flood destroyed most of the 8-mile-long Bonnie Clare Road Road (aka North Highway or Scotty's Castle Road). Bonnie Clare Road is closed from the park boundary (where it becomes NV-267) to the junction of North Highway and Ubehebe Crater road near Grapevine Ranger Station. Federal Highway Administration redesigned the road to increase its resistance to future floods.REPAIRS COMPLETED. However, Bonnie Clare Road will remain closed to the public until safety hazards from other construction projects are done. REDAMAGED: Most of the road weathered the 2022 storms and remnants of Hurricane Hilary in August 2023 very well due to the armoring that was added after the 2015 flood. In January 2023, flooding caused by an atmospheric river undercut and broke about 250 feet of pavement at Cottonwood Corner. REPAIRS COMPLETED in 2025. The 8-mile section of Scotty's Castle Road between Grapevine and the park boundary (Bonnie Clare Road) will remain closed to the public until Scotty's Castle if fully reopened. NPS / Abby Wines Historic FenceAlbert Johnson marked his property boundary with straight lines of concrete fenceposts stamped with a "J" (for Johnson) and "S" (for Scotty, perpetuating the myth of Scotty's Castle). Over a mile of concrete fence posts were washed out. The section of the fence adjacent to Bonnie Clare Road has been reproduced and installed by the same contractors who rebuilt the road. Condition assessments are underway for the damaged portions of the fence not adjacent to the road.REPAIRS PARTIALLY COMPLETED. The portion of the fence adjacent to Bonnie Clare Road has been repaired. The portion not adjacent to the road is not on an immediate workplan.
NPS photo Water systemThe spring house, one of two reservoirs, and the 4,000-foot pipeline were destroyed.TEMPORARY FIX: A temporary water line was installed by August 2016. This was done to supply water to fire sprinklers in the historic buildings. Unfortunately, the garage and longshed did not have sprinklers. REPAIRS COMPLETED: The water main pipe was replaced from September 2019 to summer 2020. This included two sections of directional drilling to connect to a waterline installed under the newly-armored Bonnie Clare Road. REPAIRS COMPLETED: Replacement of the destroyed spring collection gallery and reservoir tank was done in 2022. REPAIRS COMPLETED: Repair and replacement of damaged water distribution pipes was completed in October 2024. REMAINING WORK: There is more work to reactivate the chlorination facility; currently the site's water is non-potable. Additionally, the water's high mineral content is causing some issues in the new HVAC system. NPS / Abby Wines Historic PoolWas filled with mud and water, requiring removal by heavy equipment and hand tools.REPAIRS COMPLETED January 2016.
NPS photo LandscapingMud and rocks up to four feet deep surrounded several buildings and covered the parking lot and picnic area. Pedestrian walkways were damaged. NPS ElectricityOver 20 power poles were washed away. Lack of power and HVAC threatened the historic objects within the castle, which were removed for safe keeping.REPAIRS COMPLETED: Southern California Edison replaced the power line to Scotty's Castle by March 2016. REPAIRS COMPLETED: Phase 1 (of 2) of power distribution work within the historic district was completed in summer 2020. REPAIRS COMPLETED. Phase 2 of the electrical repairs completed in June 2024. NPS SewerThe leach field and septic tank were destroyed by the flood. Pipes that collect and transport sewage to the septic tank were clogged with rocks and damaged.REPAIRS COMPLETED: the leach field and septic tank were replaced in 2020. REPAIRS COMPLETED: a related project to damaged wastewater collection pipes within the historic district was completed in June 2024.
Tepa Companies HVAC for Main HouseOutside temperatures at Scotty's Castle range from 15 to 115 degrees F. Temperature and humidity fluctuations cause damage to museum collections, especially organic materials such as clothing, wooden furniture, and woven Timbisha Shoshone baskets. The Main House was heated and cooled by individual HVAC units in the basement, which weren't able to maintain a stable temperature for the museum collection's preservation. Those units were also discharging large amounts of chlorinated water into the desert, in violation of water codes. Several of those machines were damaged during the flood.REPAIR COMPLETED: A cooling tower, chiller, and boiler were built in and behind the historic Stables. Hydronic pipes were installed in trenches and in the historic tunnels that carry heated and cooled liquid to air handlers in the Main House basement that will provide climate control for the building interior. Completed October 2024. PENDING: The high mineral content of the water is causing some issues in the new HVAC system.
NPS/Bob Greenburg Museum collection139,000 archives, furnishings, and other artifacts are threatened by lack of heating, air conditioning, humidity control and fire suppression. The museum collection has been moved to temporary storage away from the park.PENDING: The museum collection will be returned to display in the Castle. PENDING: The portion of the historic collection that was previously stored in outbuildings cannot be responsibly returned to Scotty's Castle due to flood risks. The park is seeking long-term storage options. NPS HaciendaThis historic building serves as staff housing (top floor) and staff offices (basement floor). Damaged due mud up to four feet thick that was deposited inside the building. An architectural/engineering firm designed repairs and the California State Historic Preservation Office concurred with the designs.COMPLETED: winter 2021/2022.
NPS Scotty's Castle (Main House & Annex)The roof leaked in several places, allowing moisture into the building.REPAIRS PARTIALLY COMPLETED: Minor repairs have taken place; more are needed.

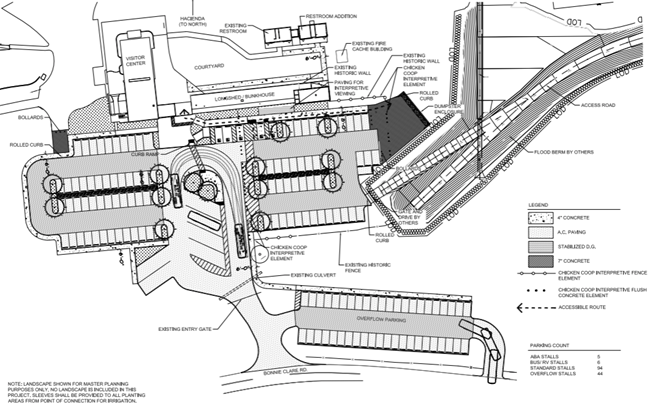

NPS Parking LotThe parking lot got damaged by flooding and then has served as a staging area for equipment and supplies while working on projects throughout the historic district. The replacement parking lot design adds accessible parking spaces and provides parking for large vehicles such as RVs and tour buses.PENDING: The NPS plans to put this project out to bid in FY27.

NPS Visitor Contact Station (Historic Gas Tank House)A larger building, the historic Garage, served as the modern Scotty's Castle Visitor Center. The Garage burned down while under repair in 2021. Funds are not immediately available to rebuild the Garage. Therefore, the NPS will repurpose the smaller Gas Tank House building as a visitor contact station.PENDING: This contract is scheduled to go out to bid in FY2027. Flood Photo & Video Gallery
