Towpath Resurfacing Project

Newly resurfaced towpath at the Monocacy Aqueduct (MM 42.2)
Newly resurfaced towpath at the Monocacy Aqueduct (MM 42.2)

NPS Photo

You might see some areas of towpath being resurfaced...What's going on?

In short, the park is working to resurface the towpath in phases over the next five-to-ten years. In 2016, the C&O Canal National Historical Park partnered with the Allegheny Trail Alliance (ATA) to assess the condition of the park's 184.5 miles of towpath. Founded in 1995, the ATA is charged with maintaining the Great Allegheny Passage, a 150 mile rail-trail that stretches from Pittsburgh, Pennslyvania to Cumberland, Maryland.

Through this assessment, the park was able to develop a comprehensive, mile-by-mile review of towpath conditions, including drainage issues, grass strips, potholes, roots, and other obstructions. This review helped to identify some of the worst sections of towpath and prioritize resurfacing efforts.

Where is work currently taking place?

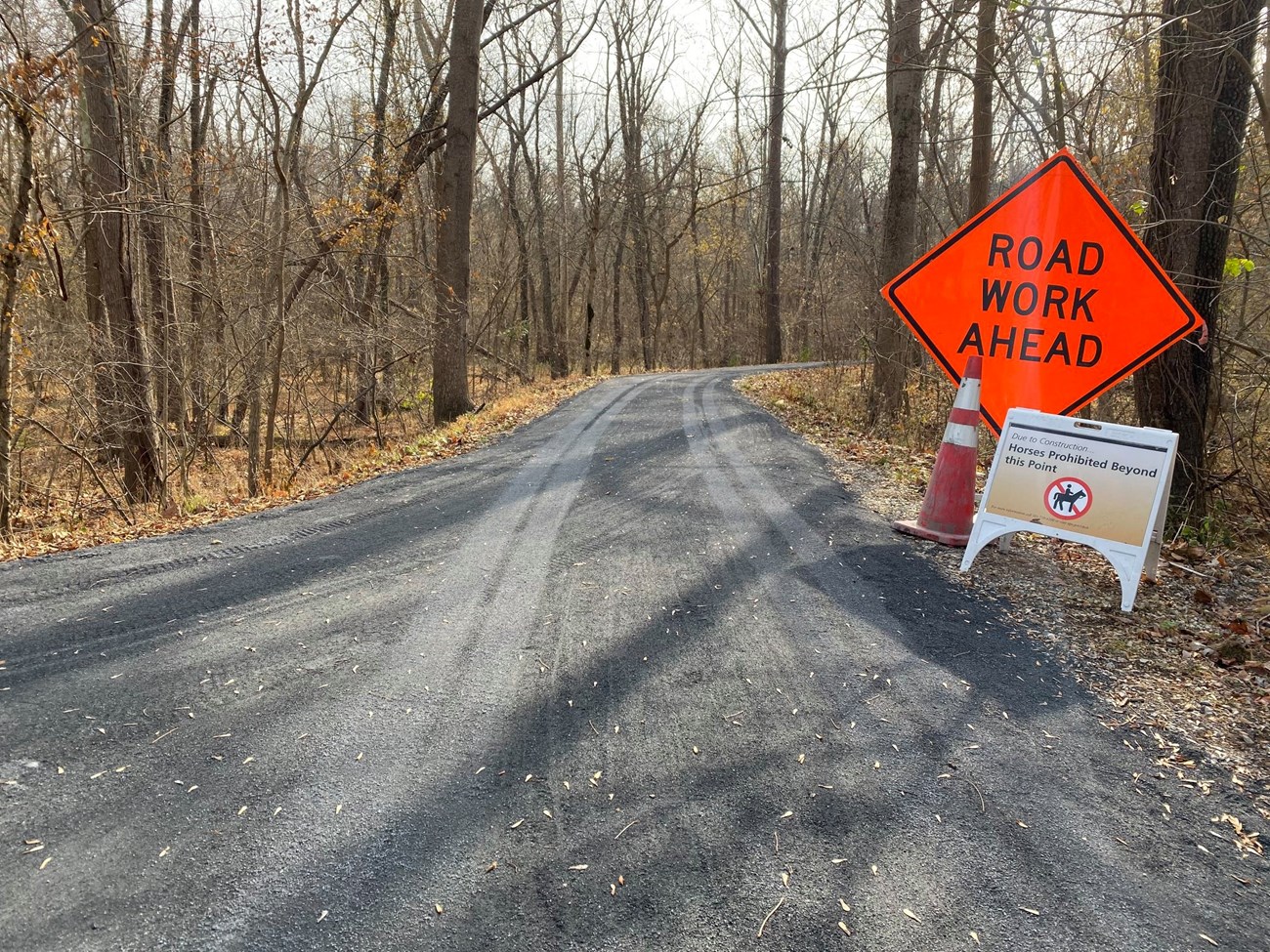

The most recent phase of resurfacing stretches from Paw Paw Tunnel (mile 156) and Spring Gap (mile 173). This phase of work is expected to be completed in Spring 2024. When work is active, visitors may see temporary horseback riding restrictions. Please read more on our Horseback Riding page.

Why are we doing this work?

Due to the proximity to the Potomac River and the constant threat of floods and washouts, the park wanted to develop methods of resurfacing that are historic, durable, and long lasting.

The goal of the resurfacing project is threefold:

  1. To maintain the historic integrity and character of the towpath
  2. To maintain the durability of the towpath during high water and flood events
  3. To provide a smooth, level surface for hikers, bikers, and visitors who utilize the towpath on a daily basis

The resurfacing techniques are not catered to one particular usage group, such as runners or bicyclists. Rather, the park is piloting a new resurfacing model to make the towpath as durable as possible for all park users.

What are the resurfaced layers made of?

The towpath is NOT being paved. The base layer of the new towpath surface is crush and run gravel, also known as CR-6. The top layer is stone dust, also known as AASHTO-10. The crush and run layer creates an adequate drainage system, so that heavy rainfall can easily drain off the towpath. The stone dust layer at the top adds a nice, smooth surface.

What is the process for resurfacing the towpath?

  1. Use skid steers to remove the grass strip from the center of towpath (if necessary)
  2. Grade the edges of the towpath so water can run off smoothly
  3. Lay down two inches of CR-6 and roll with a roller
  4. Lay down 2 inches of AASHTO-10 and roll with a roller
  5. Seed and straw the edges of the towpath and any other areas that were disturbed by the work

What sections of towpath can I expect to be resurfaced?

Towpath resurfacing is taking place in phases over the next several years:

  1. Edwards Ferry (mile 30) to Whites Ferry (mile 35) and Brunswick (mile 54) to Ferry Hill (mile 72.5) - COMPLETE
  2. Whites Ferry (mile 35) to Brunswick (mile 54) - COMPLETE
  3. Violette’s Lock (mile 22.12) to Edwards Ferry (mile 30) - COMPLETE
  4. Ferry Hill (mile 72.5) to Big Slackwater (mile 86.7) - COMPLETE
  5. Western Maryland Rail Trail Towpath Connector (mile 137.8 - 140.7) - COMPLETE
  6. Paw Paw Tunnel (mile 156) to Spring Gap (mile 173) - Currently in progress
  7. Big Pool (mile 112) to Licking Creek (mile 116) - Summer 2024
  8. Spring Gap (Mile 173) to Cumberland (Mile 184.5) - Future Project
  9. Fifteenmile Creek (mile 140) to Paw Paw Tunnel (mile 155) - Future Project

Where does funding for this project come from?

Funding for the project comes from a variety of sources, including the National Park Service and grants from the State of Maryland. To date, $4.5 million dollars has been spent rehabbing these sections.

The C&O Canal Trust, the park's philanthropic partner, provides funding from donors each year covering fees associated with engineering consultation related to resurfacing.

Still have questions?

Send us an email or give us a call during regular business hours at 301-739-4200.

A photo of a dirt path surrounded by grass running beneath a metal bridge. A photo of a dirt path surrounded by grass running beneath a metal bridge.

Left image

Before: The towpath at Whites Ferry (mile 35.5) before resurfacing efforts. -
Credit: NPS Photo

Right image

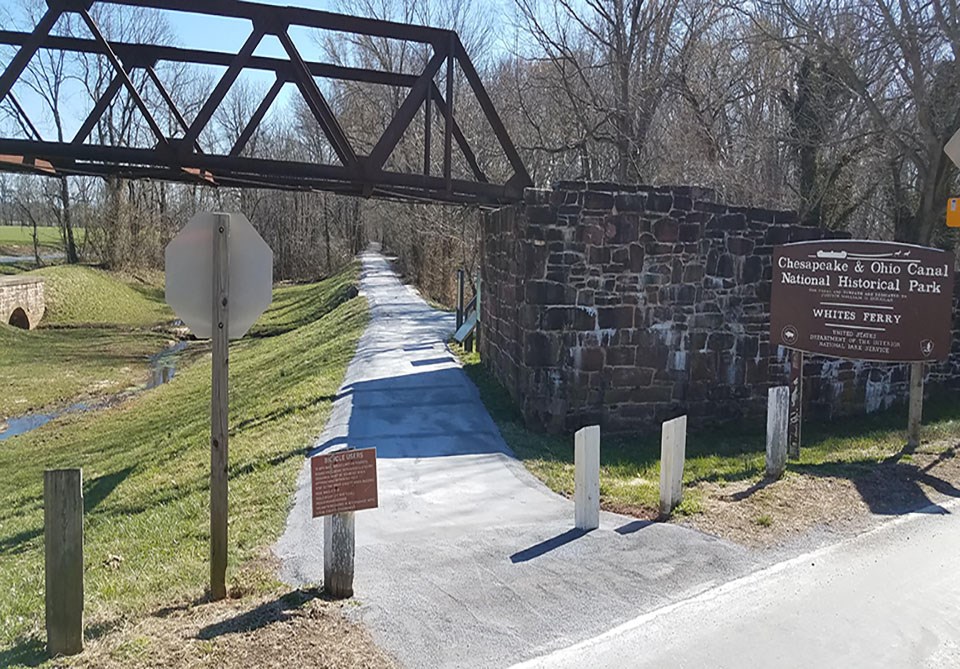

After: The towpath at Whites Ferry (mile 35.5) after resurfacing efforts. -
Credit: NPS Photo
