Road Construction

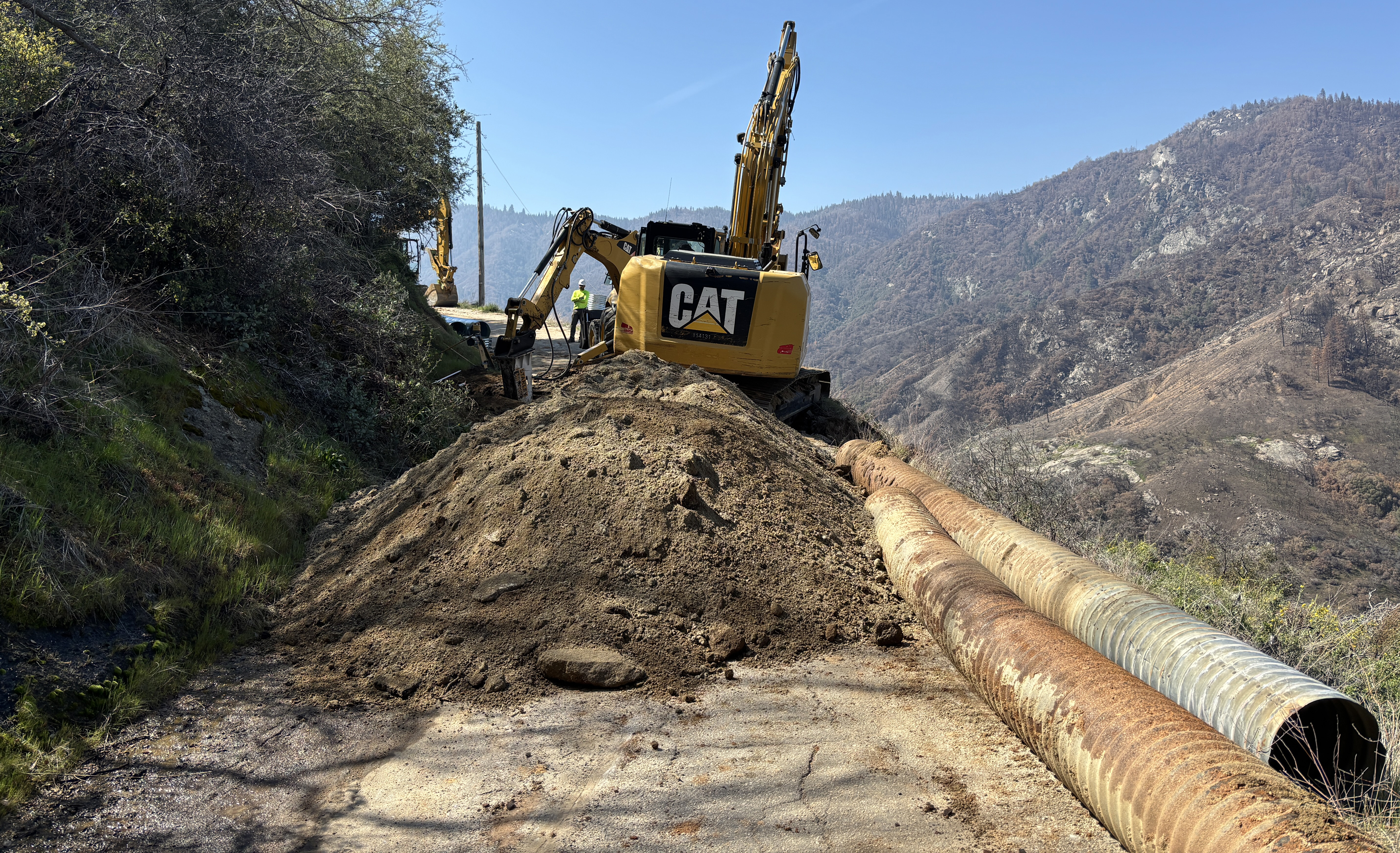

A large pile of dirt next to two long corrugated metal culvert pipes completely block a narrow road in the mountains. A yellow and black piece of construction equipment with the word "Cat" works on the road behind the pile.
Road construction to replace drainage culverts on Mineral King Road will impact traffic on weekdays in 2025.

NPS Photo



General Information

This page describes current road construction within the park in detail. The page will be updated as needed when major road work is happening in the parks. Please see the Road Conditions page for information on all park roads.



Current Road Construction

Mineral King Road (2025 - 2027)

Mineral King Road is a narrow, curvy mountain road that enters the Mineral King area of Sequoia National Park. The Mineral King area begins 9.4 miles (15.1 km) or a 45-minute drive above its junction with Highway 198, just before Lookout Point.

There will be major road construction on Mineral King Road through 2027. This includes road closures and traffic delays. Visitors will have to pass through the road construction to access the Mineral King area. Within the construction zone, active construction sites may move from day to day. At times, some campgrounds, trailheads, or private inholdings (such as Silver City Resort), will be in the construction zone.

This closure is within the Mineral King area, separate from the main areas of Sequoia National Park. Any closures and delays in this area will not affect visitors going through the main Sequoia National Park Entrance.



Mineral King Road Construction Closure And Delay Schedule September 2–October 29

Columbus Day (Federal Holiday) : No closures or delays from noon on Friday, October 10, through 7 am on Tuesday, October 14.

The schedule may change at any time due to weather or emergencies.
A summary of weekday road closures and delays on Mineral King Road between September 2 and October 29, 2025.
Day of the Week Road Closure And Delay Schedule From 7 am to 7 pm From 7 pm to 7 am
Monday – Thursday 7 am – 10 am: Up to 30-minute delays
10 am – 4 pm: Full closure
4 pm – 7 pm: Up to 30-minute delays
No closures or delays
Friday – Saturday 7 am – 8 am: No closures or delays
8 am – 7 pm: Full closure, except 3 opportunities to pass through the construction zone (see below)

10 am, 1 pm, and 4 pm: Vehicles must be at a closure point location at 10 am, 1 pm, or 4 pm to be guaranteed passage through the construction zone. Rounds of traffic in each direction will be allowed to pass through at each time.
No closures or delays
Sunday No closures or delays No closures or delays
Federal Holidays: Columbus Day (October 13), see details above this table. No closures or delays No closures or delays

Mineral King Road Construction Location September 2 – October 29

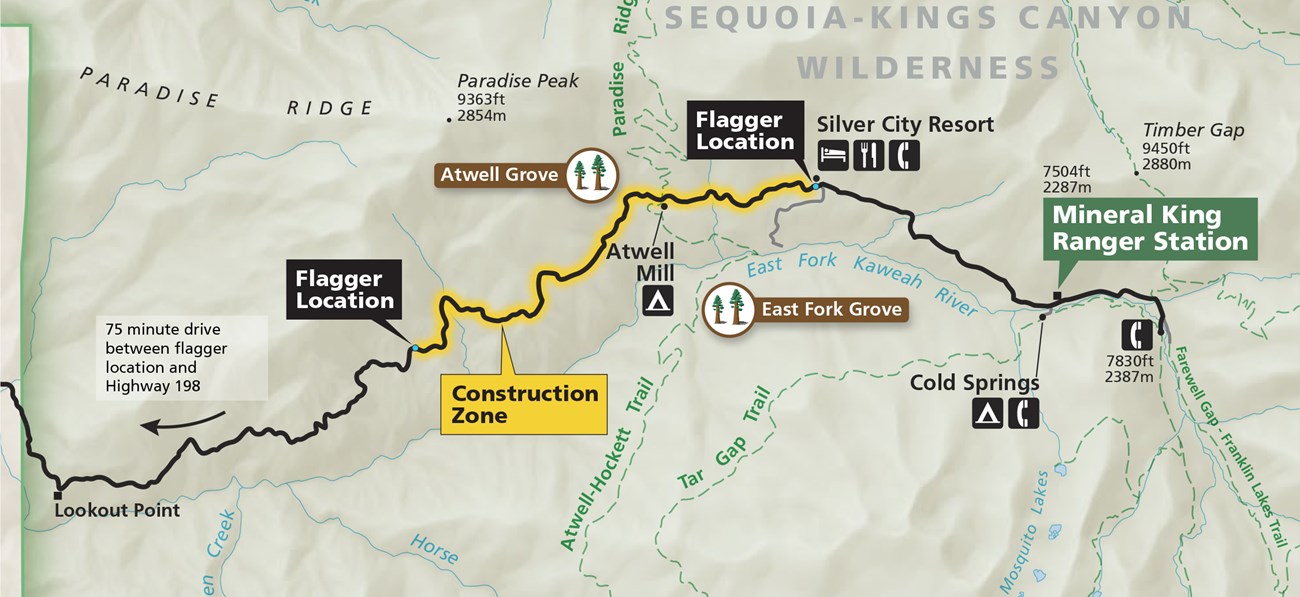

A map of the mineral king area with the construction zone highlighted in yellow with flagger locations in large black boxes. Detailed information on the map is described in the text.

The current construction zone on Mineral King Road begins approximately 15 miles (24.1 km) from the junction on Highway 198 and ends 5.5 miles (9 km) east at Silver City Resort. The current estimated drive time through the 5.5 mile (9 km) section of road within the construction area is about 60 minutes for a single car. Actual times will vary based on traffic.

Atwell Mill Campground and Associated Trails: This closure includes Atwell Mill campground, associated trailheads, and some private inholdings. On certain days, travel to and from the campground will not be possible during large portions of the day. There will be scheduled passthrough times on certain days, where travel to and from the campground will be possible. Please refer to the schedule table above for detailed information.

Last updated: September 5, 2025
