North Parkway Construction, News, and Impacts

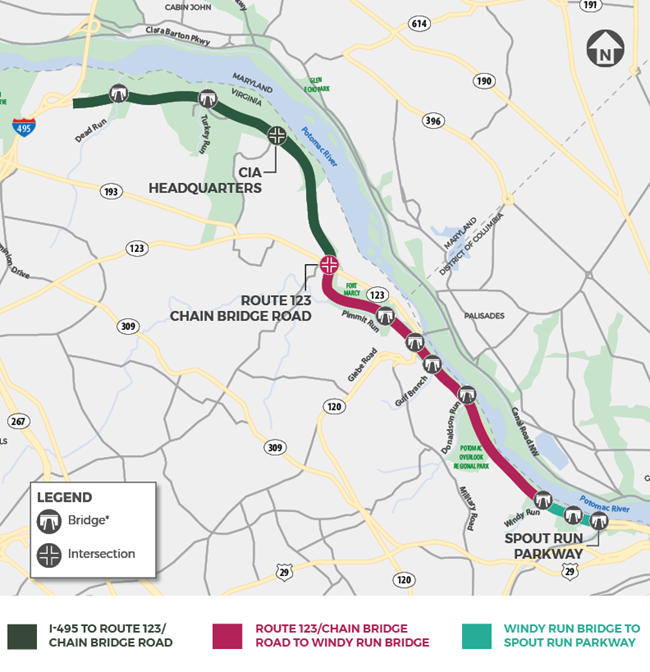

This infographic displays the project rehabilitation area
This infographic displays the project rehabilitation area

NPS

The National Park Service (NPS) has reached substantial completion of the north parkway rehabilitation project on the George Washington Memorial Parkway. The project, which began construction in 2022, improves safety and resilience through rehabilitated pavement and drainage, strengthened roadside features and restored historic overlooks. Some finishing work will continue into the spring during off-peak travel hours. Motorists can expect travel impacts once crews begin rehabilitation efforts on the Route 123 Interchange bridge.
View construction updates under Current Construction.

  • To opt in to receive email updates about traffic impacts and other news please click here.
  • To contact the project team please  e-mail us.  
  • View recordings of informational public meetings on our public meeting webpage.

Rehabilitation Completion Along the Parkway

The National Park Service has completed all major construction efforts for the Rehabilitation Project. Crews have performed the following:

  • Repaired or replaced the guardwall, upgrading motorist safety.
  • Repaired bridges, rehabilitating aging infrastructure.
  • Replaced the roadway, improving drivability and safety. 
  • Completed drainage installation and repairs, reducing erosion and sediment run off.
  • Repaired the outfalls have been repaired, completing work to improve drainage structures that discharge water to nearby streams. 
The National Park Service thanks you for your patience over the last three years as we worked to rehabilitate 7.6 miles of the parkway, improving the driving experience and safety for motorists, while maintaining the culture of this historic landmark near our nation’s capital. See below for current construction details and impacts in each segment.

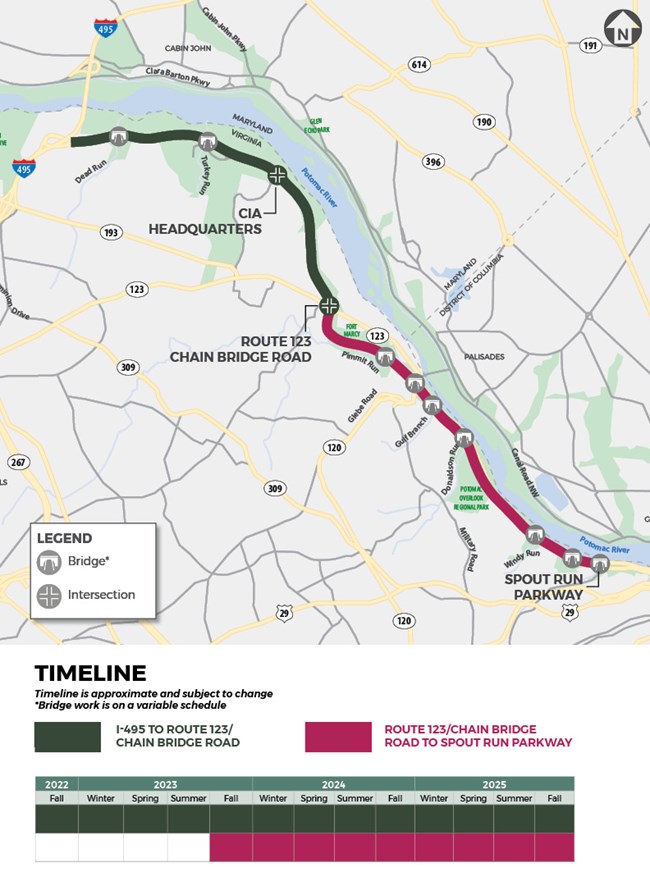

Current Construction (Updated April 2026)

I-495 to spout Run Parkway

Crews continue curb work at the I-495 Interchange. Periodic lane closures continue for median restoration, outfall planting, signage installation, and paint touch up and clean up on bridges between I-495 and Spout Run Parkway.

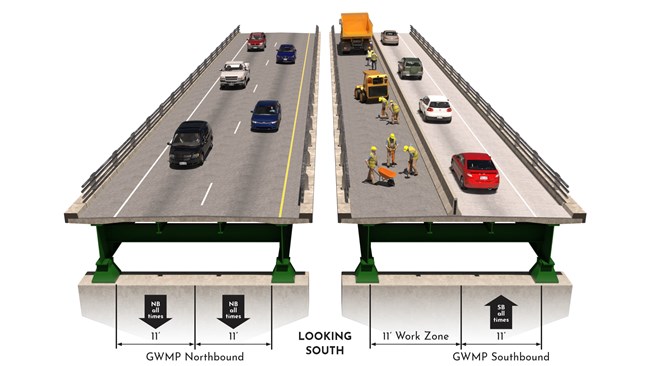

Bridge Construction

Crews continue working on under bridge platform removal at Gulf Branch Bridge. No additional traffic delays are anticipated at this time.

All work is weather permitting. In the event of inclement weather, work will be rescheduled. Any changes in the closure schedule above will be reflected on this page.

Construction Zone Safety

Please slow down and be cautious while driving through work zones on the parkway. Commercial vehicles are restricted from the parkway at all times. Signage will direct drivers to the appropriate lanes.

  • Drivers should observe traffic signs for updated information.
  • A 40 MPH speed limit remains in effect from the I-495 interchange to Spout Run Parkway to help keep construction crew and motorists safe. This speed limit will be in place for the remainder of the project and is enforced as such.
  • To avoid traffic delays on the northern section of the parkway, drivers should consider alternate routes and plan for additional travel time.
  • Remember vehicles over 10,000 lbs. are always prohibited from using the parkway.

Mill and Overlay Map
Resurfacing work will occur in two segments from Spout Run Parkway South and I-395 and between Ronald Reagan Washington National Airport and Alexandria.

NPS

Additional Rehabilitation Work on the George Washington Memorial Parkway
The National Park Service has identified additional rehabilitation work on the George Washington Memorial Parkway. This work is underway, taking advantage of the current construction workforce to facilitate this additional work and reduce traffic impacts.

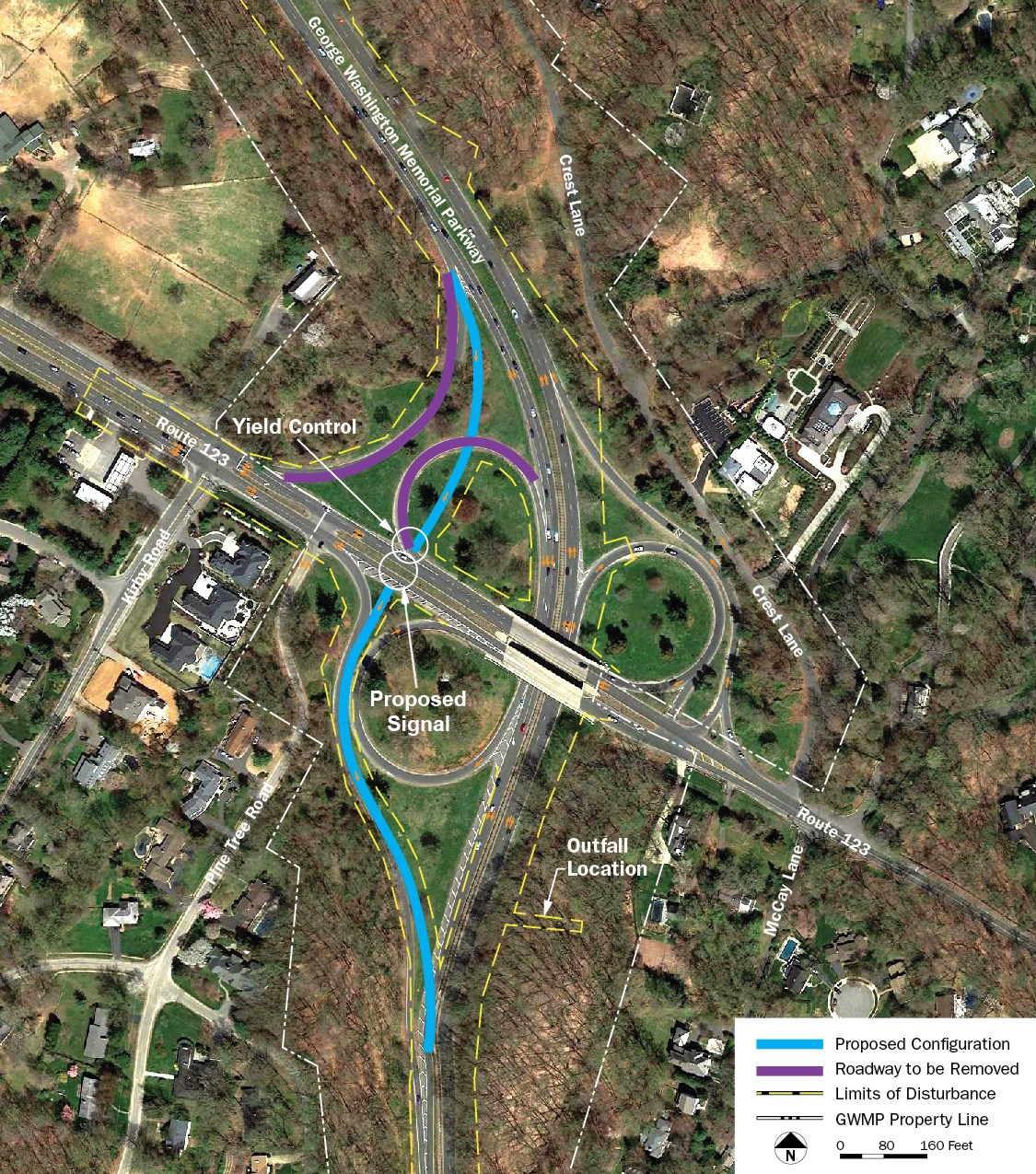

  • Route 123 Interchange Bridge Work and Traffic Impacts 
    Structural repairs on the Route 123 Interchange bridge are underway as part of efforts to rehabilitate aging infrastructure. To accommodate ongoing construction, the deceleration lane on the exit ramp has been shortened and single lane closures are in effect. This month, crews will close one northbound lane to perform repairs. The southbound lanes will remain open. At least one lane will remain open in each direction during rush hour. Next, crews will close one southbound lane to continue work. Repairs on the bridge are anticipated to last through mid-July.

  • Additional Mill and Overlay Work

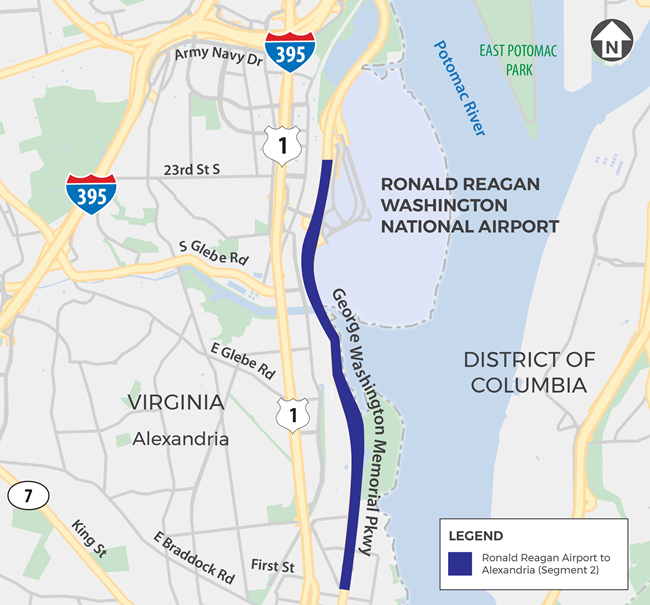

    Crews began nighttime milling and paving between Spout Run Parkway and I-395. Once crews complete work in this segment, they will begin milling and paving the roadway from Ronald Reagan Washington National Airport to First Street in Alexandria, Virginia, weather permitting. Crews will remove a layer of the northbound and southbound lanes and rehabilitate the asphalt to extend the life of the roadway in this section of the parkway. Work is expected to continue until mid-June.

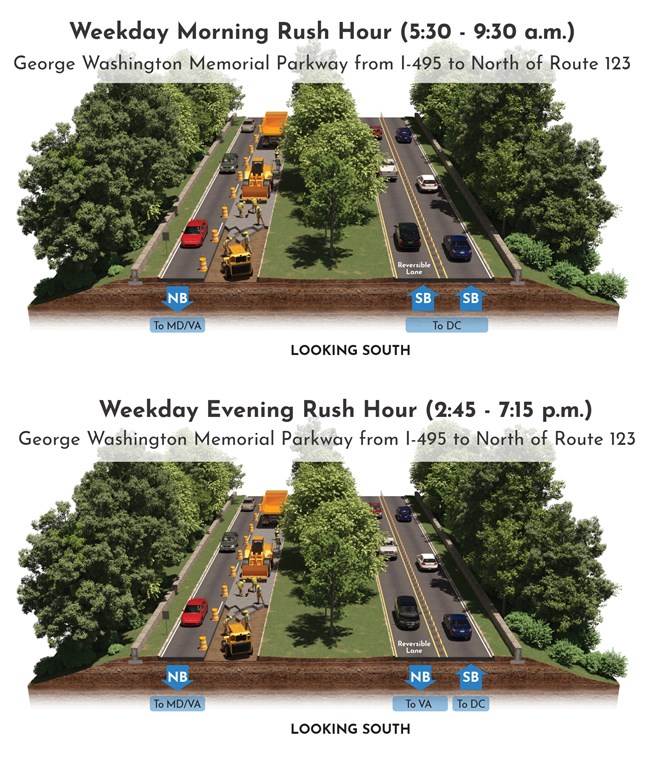

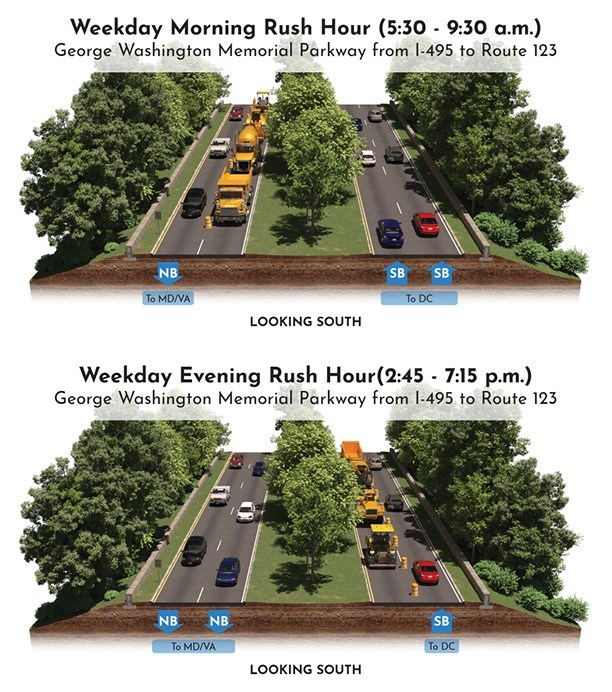

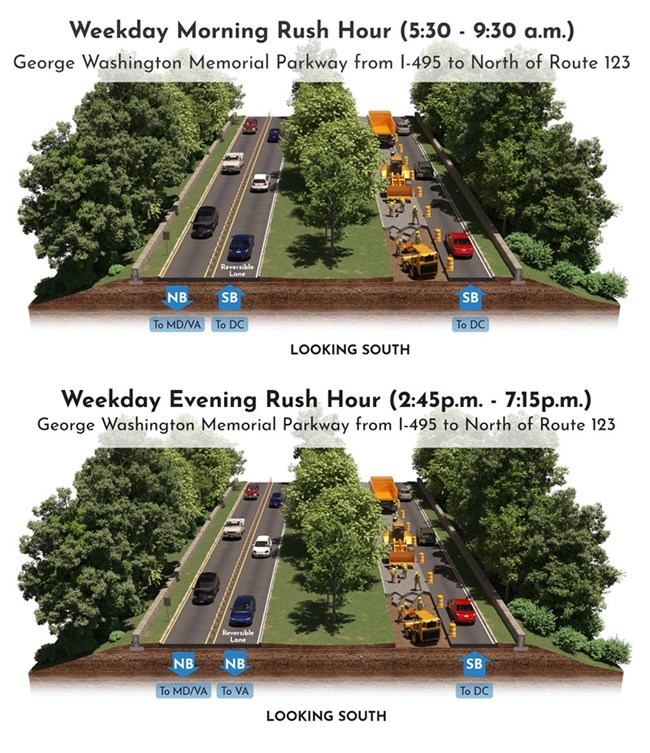

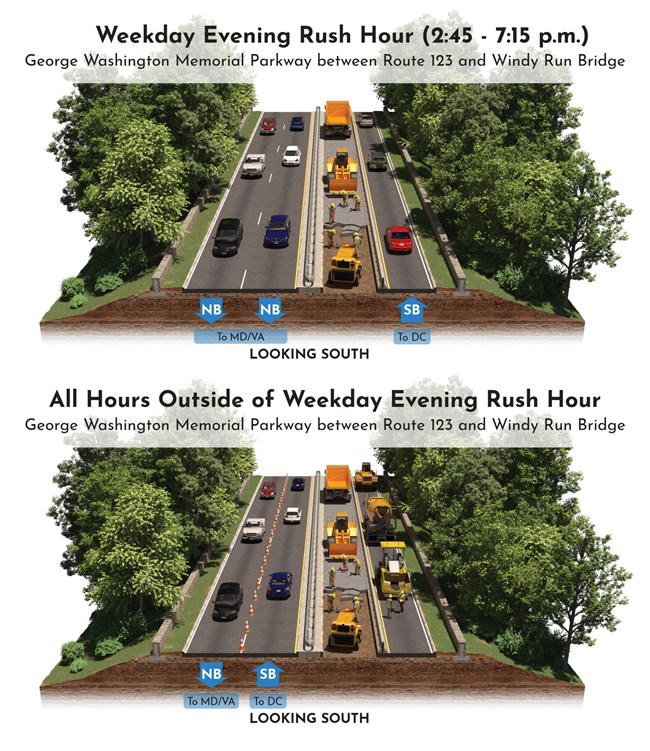

    Traffic pattern

    Morning rush hour on weekdays (5:30 to 9:30 a.m.): Drivers will have two southbound lanes and one northbound lane. 

    Evening rush hour on weekdays (2:45 to 7:15 p.m.): Drivers will have two northbound lanes and one southbound lane.

    Midday on weekdays (9:30 a.m. to 2:45 p.m.), overnight (7:15 p.m. to 5:30 a.m.), and on weekends: Drivers will have one lane open in each direction. 

Drivers should expect periodic ramp closures entering and exiting the parkway as crews continue work in the area. Drivers should consider alternate routes.

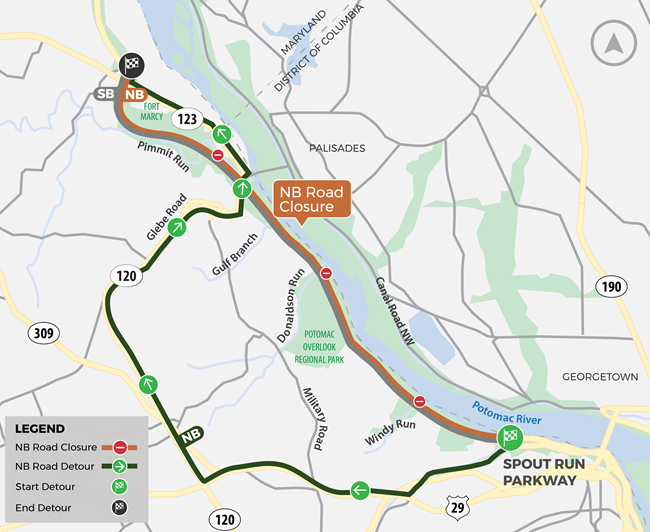

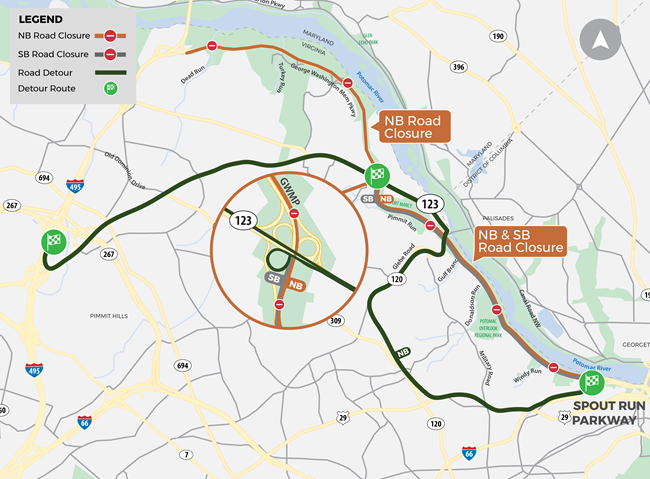

April Nighttime Ramp Closures – Spout Run Parkway to I-395

Ramps entering GWMP southbound from:

  • Spout Run Parkway
  • Arlington Blvd
  • Washington Blvd

Ramps exiting GWMP southbound to:

  • Key Bridge
  • I-66
  • Memorial Ave
  • Washinton Blvd
  • I-395

Ramps entering GWMP northbound from:

  • I-395
  • Arlington Blvd
  • I-66
  • Key Bridge

Ramps exiting GWMP northbound to:

  • Washington Blvd
  • Spout Run Parkway

A portion of the Columbia Island parking lot near the LBJ Memorial Grove on the Potomac will be used as a staging area by the construction crew for the duration of the project.

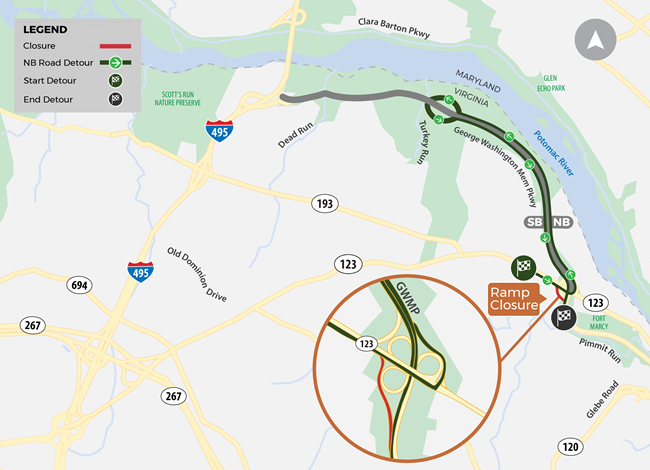

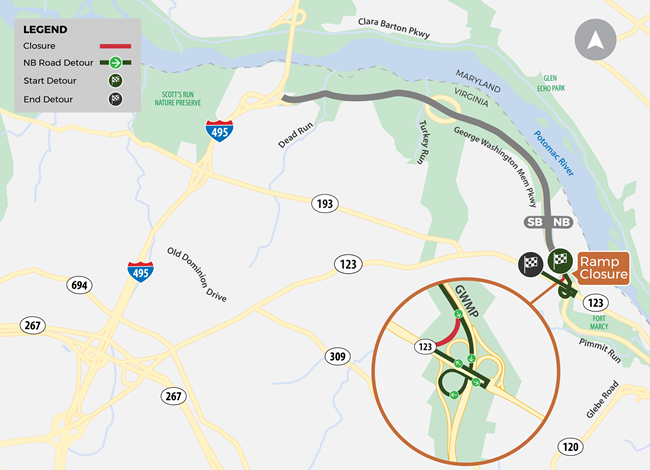

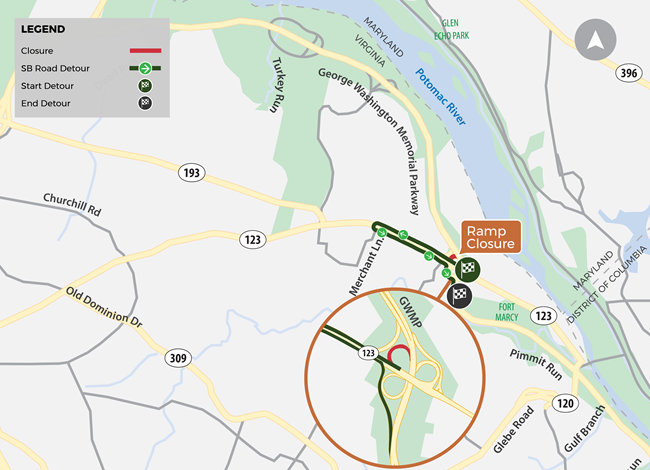

Detour map
Motorists traveling on the southbound parkway should continue to Route 123 to access the northbound parkway and Turkey Run Loop Road.

NPS

Turkey Run Loop Drainage Repairs

The outer lane of Turkey Run Loop Road is closed for drainage repairs on weekdays from 7 a.m. to 5 p.m. Closures are needed to upgrade roadside drainage and improve stormwater flow, helping protect the roadway and improve safety. These upgrades will strengthen the parkway’s infrastructure, reduce the risk of future roadway damage, and support a safer, more reliable travel experience. Crews will work on the inner lane of the loop first and once complete, proceed to work on the outer lane of the loop. Detours will be in place during each lane closure to maintain access between the parkway and Turkey Run Loop Road. 

Detour information:
Inner Turkey Run Loop Road closure:

  • Access from the parkway: Turkey Run Loop Road is accessible only from the northbound parkway. Southbound drivers must continue to Route 123 and return via the northbound parkway.
  • Access to the parkway: Drivers exiting Turkey Run Loop Road may only access the southbound parkway. Northbound access is closed. Follow detour signs to Route 123 to reach the northbound parkway.

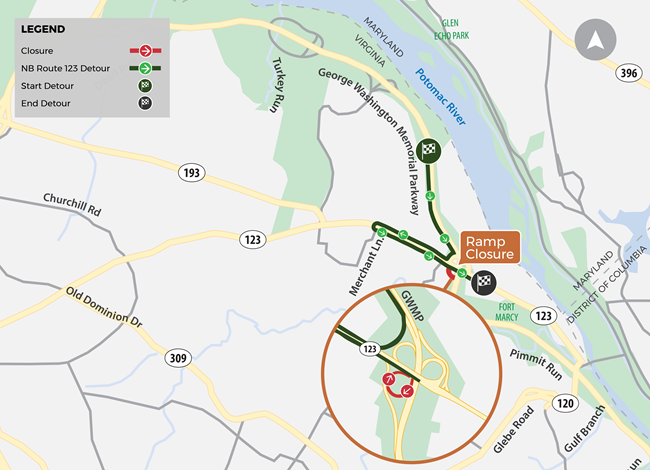

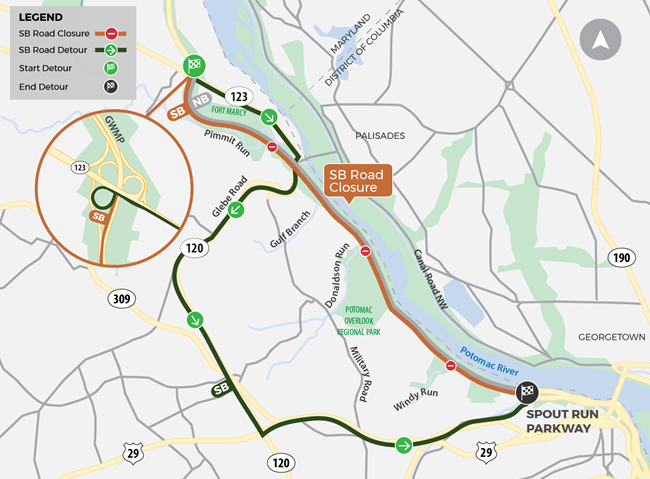

Detour map
Motorists traveling on the northbound parkway should continue to I-495 south, turn at Georgetown Pike and proceed to the southbound parkway and Turkey Run Loop Road.

NPS

Outer Turkey Run Loop Road closure:  

  • Access from the parkway: Drivers can access The Turkey Run Loop Road from the southbound parkway. Northbound drivers must continue to I-495 South, exit at Georgetown Pike, and return via the southbound parkway. No change for drivers traveling southbound on the parkway.  
  • Access to the parkway: Drivers exiting Turkey Run Loop Road may access the northbound parkway. Southbound access is closed. Follow detour signs to I-495 South, Georgetown Pike, and the southbound parkway.

Frequently Asked Questions (FAQs)

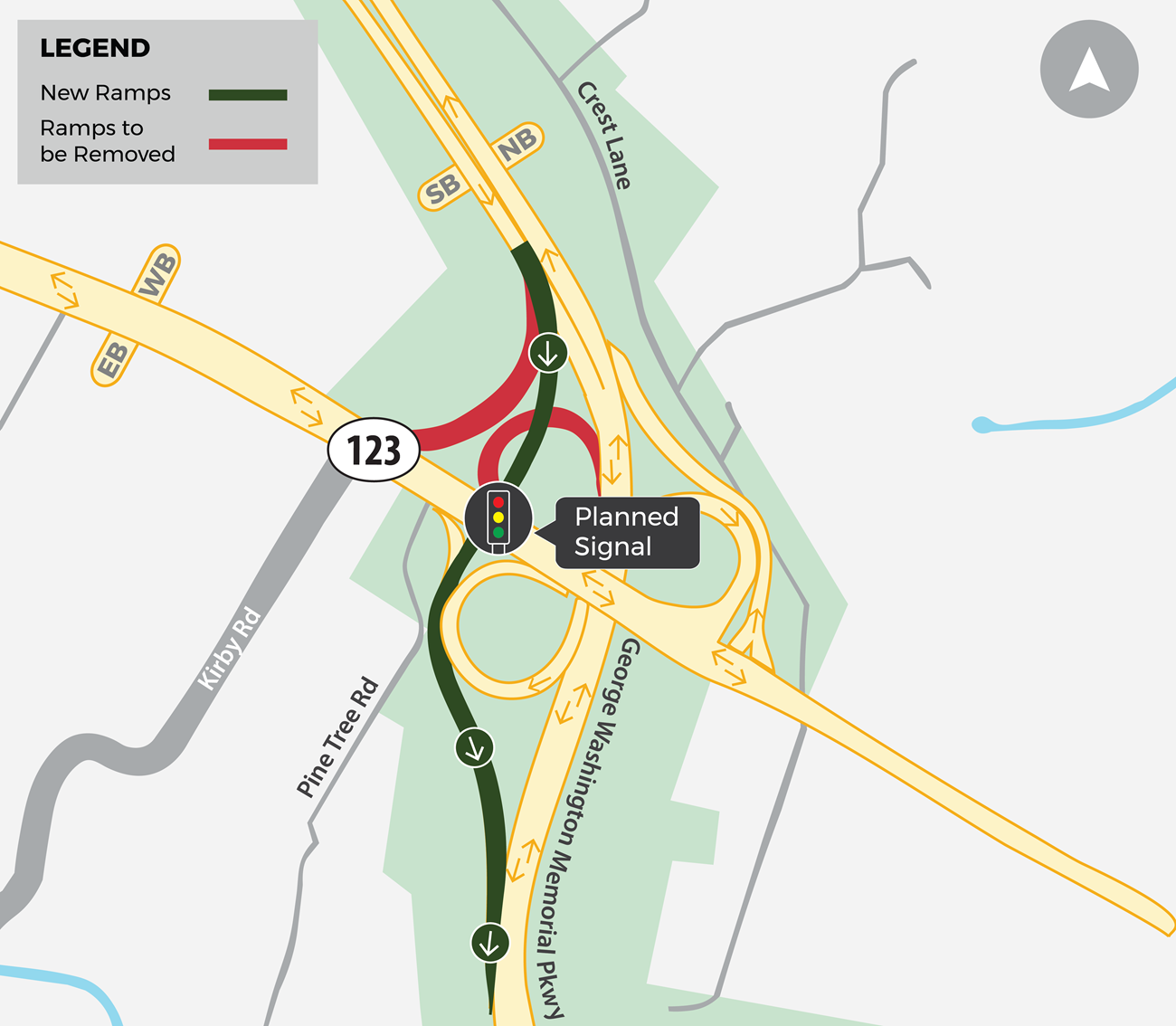

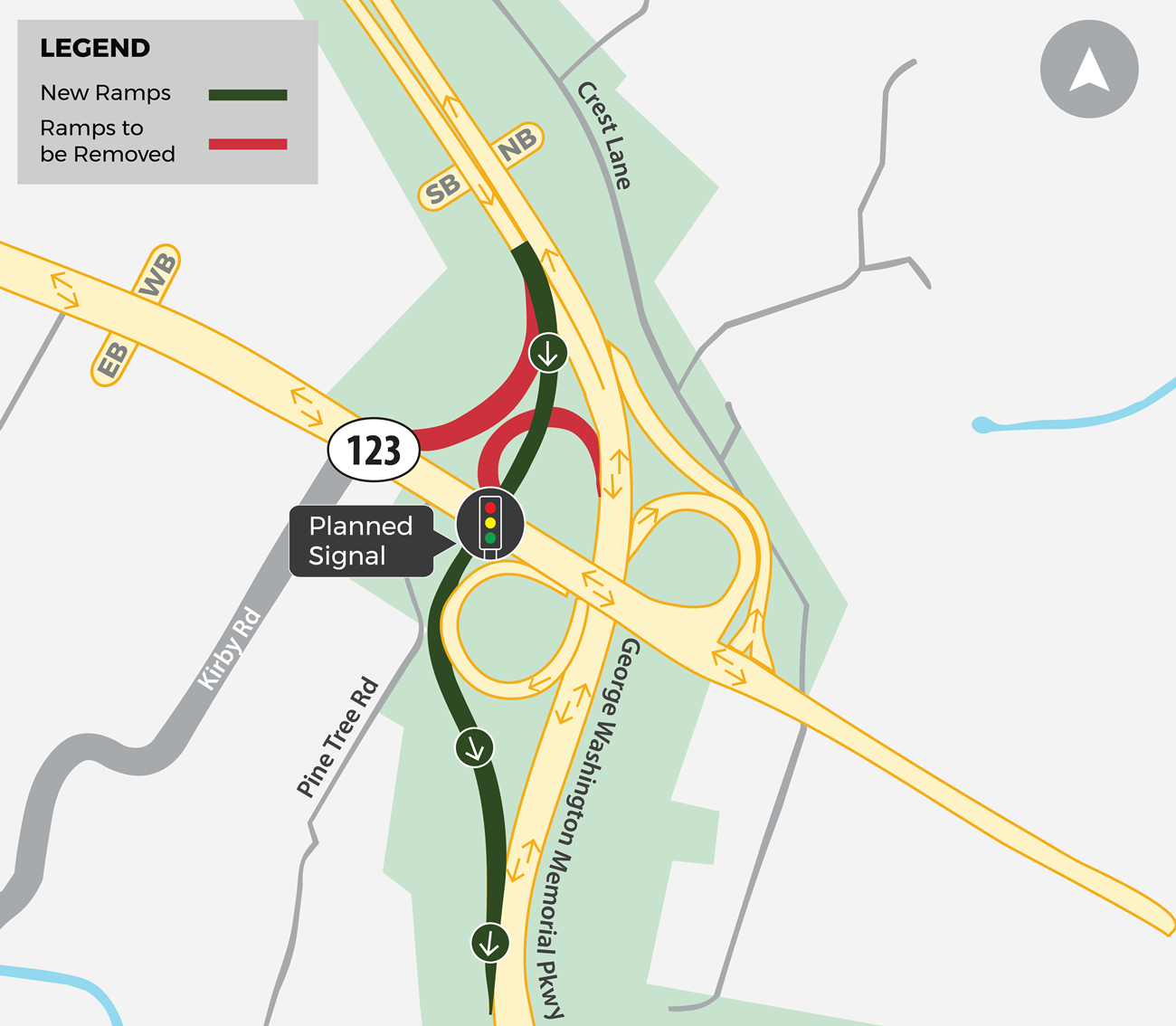

Aerial view of Route 123 and the proposed GWMP Interchange Option One. The curved sections in purple would be removed and the proposed configuration is in blue and is more linear. The Limits of Disturbance boundary is a dashed yellow line.
