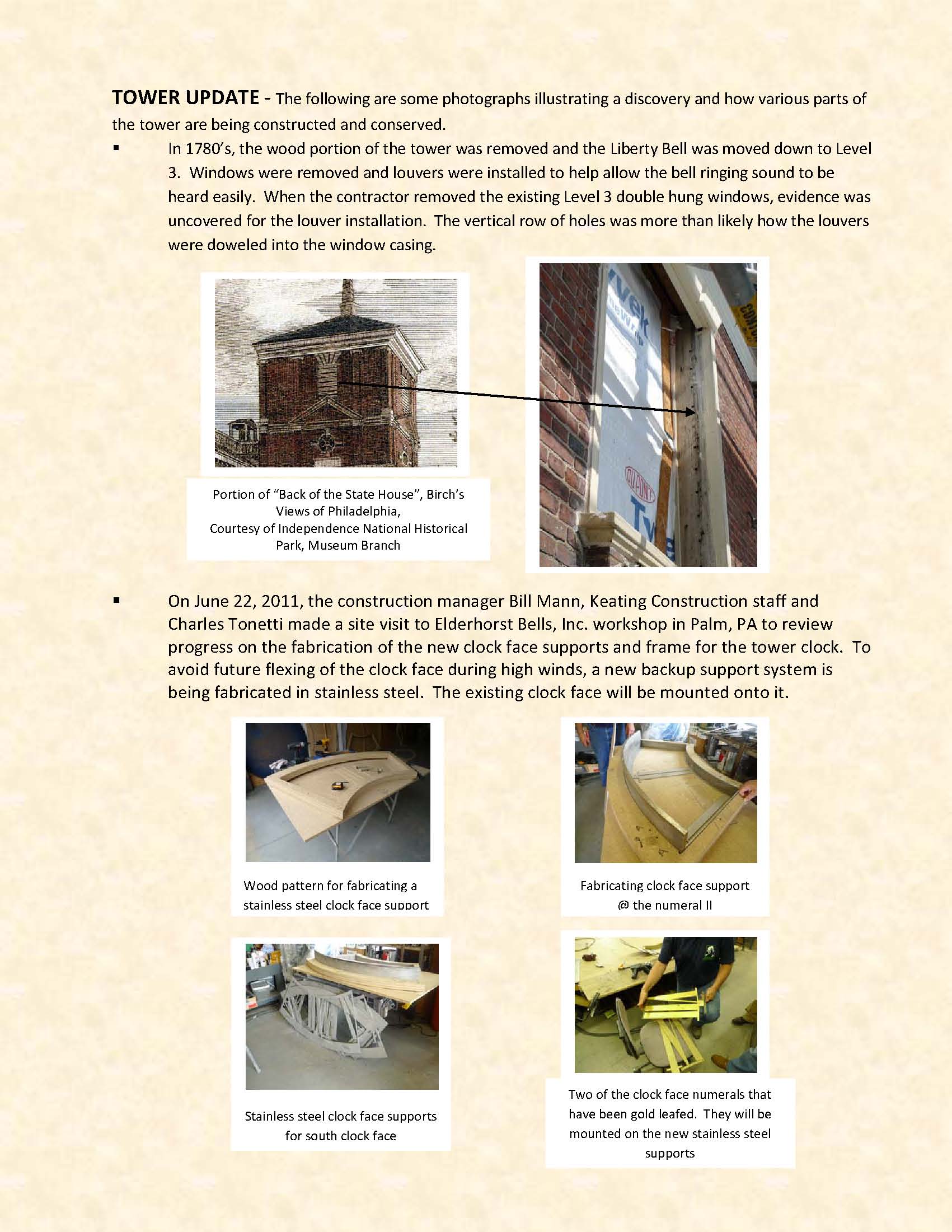

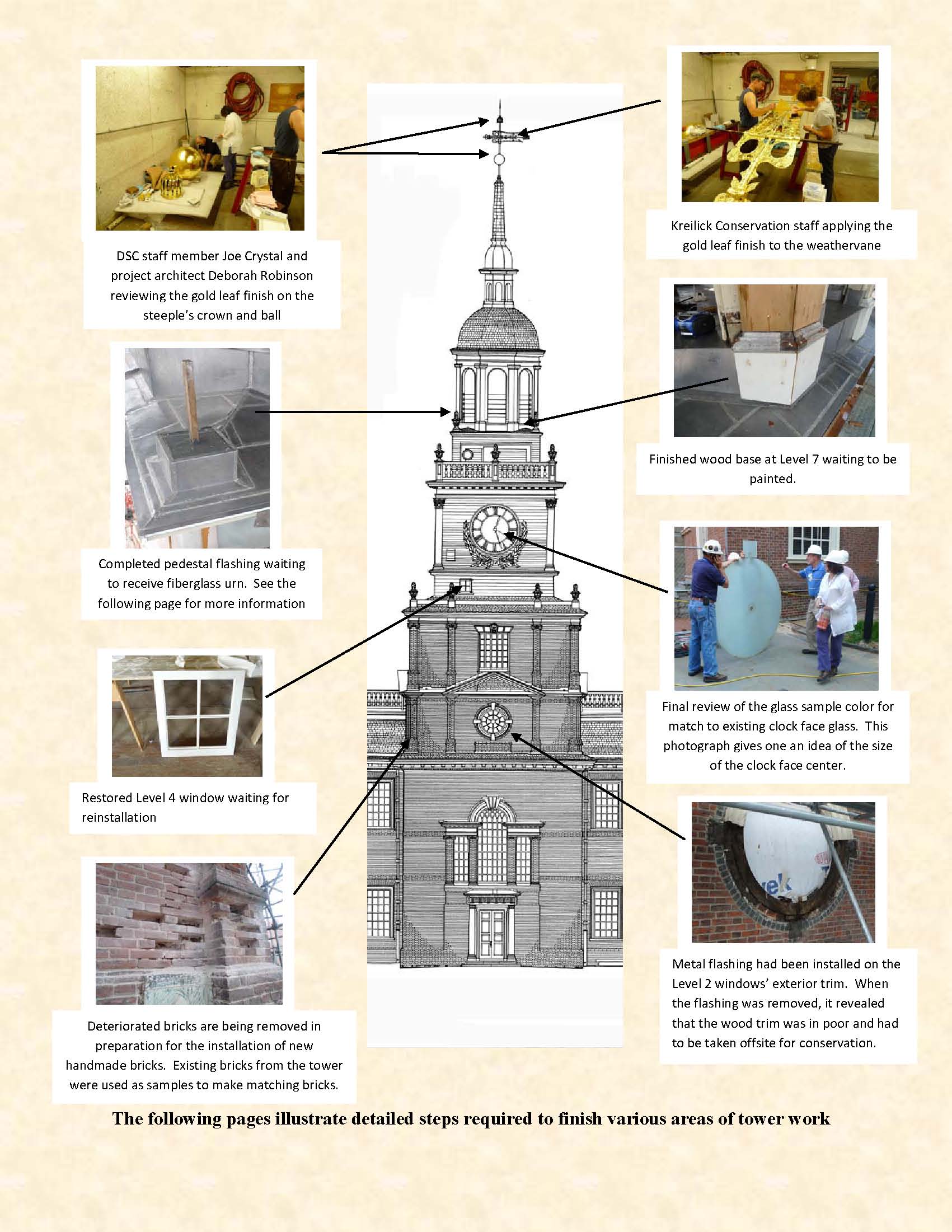

Preserving the Tower of Independence Hall
nps Independence Hall tower Photo gallery Independence Hall Tower ribbon cutting ceremony Funded by $4.4 million in stimulus funds under the American Recovery and Reinvestment Act, the rehabilitation project began last July and is expected to be completed in early 2012. In June 2011, contractors installed the new stainless steel spindle that supports the weather vane, ball, and crown in addition to the highest lightening rod aerial. A crane lifted the 30 foot long, 700 pound spindle approximately 240 feet into the air to center it for the drop in, working with only 5/8" clearance to navigate the spindle down through the spire framing and anchor it properly. Work is progressing from the top down, and visitors will see the scaffolding come down in stages as portions of the project are completed. To date, the scaffolding has been lowered approximately 52 feet, revealing the restored spire and weathervane. In the upcoming months as the work progresses, the scaffolding will be removed exposing more and more of the restoration. Visitors can still see an image of the iconic tower throughout the project, however, thanks to the Friends of Independence, who donated a decorative scrim to cover the scaffolding.

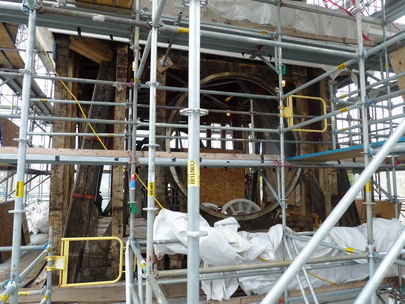

Exposed structural framing for Independence Hall Tower at the clock face level. (Independence NHP)
More Information On The Project
The work continues...click here to enlarge image

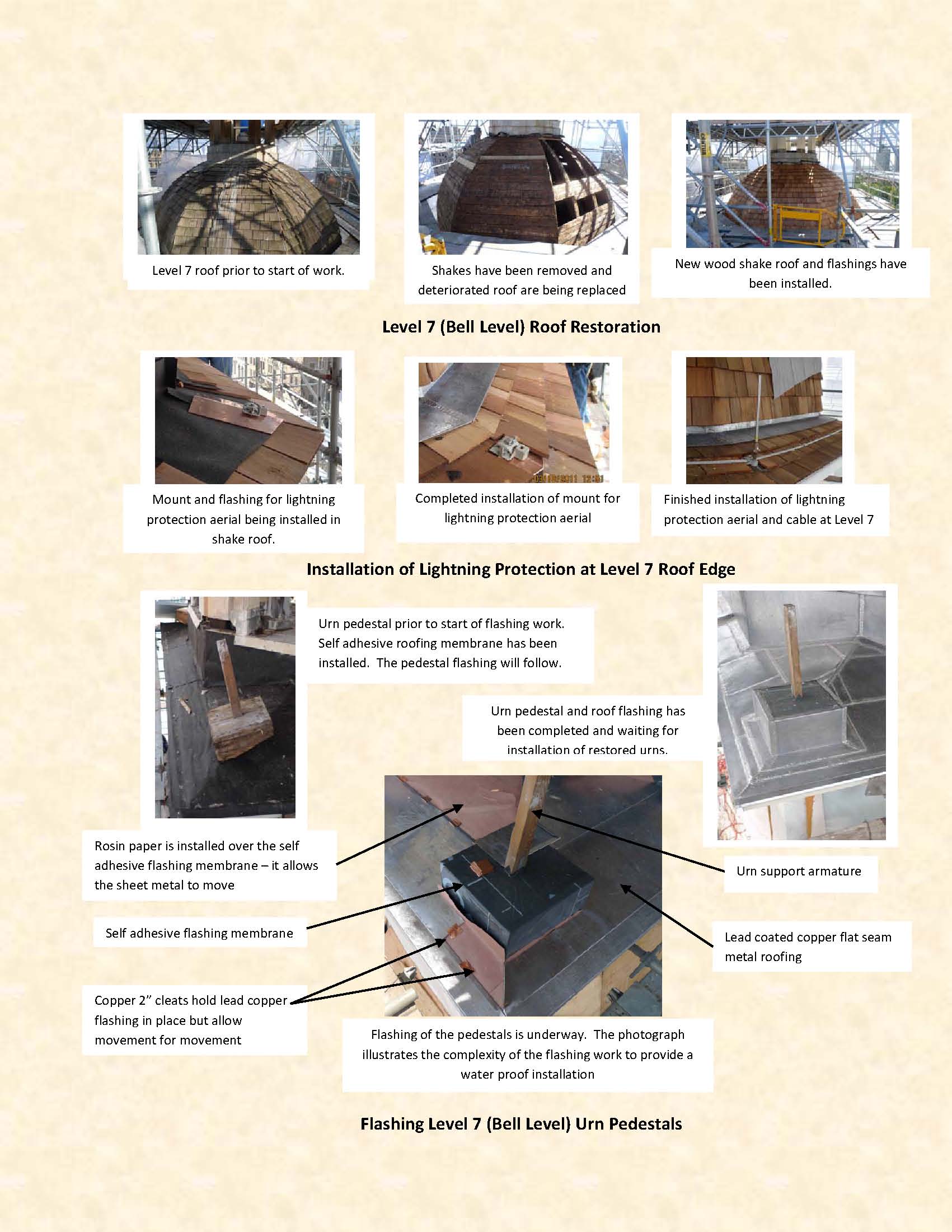

Installation of Lightning Protection at Level 7 Roof Edge |
Did You Know?
The exhibits in the Liberty Bell Center showcase the Liberty Bell’s role as a symbol in the abolitionist movement, the fight for women’s suffrage and the Civil Rights struggles of the 1960’s.
